Example for Productivity Analysis and Improvement

An excavator with a bucket capacity of 3-yd3 has a standard production rate of 2,160-yd3 for an 8-hour day.  The job site productivity and the actual cycle time of this excavator under the work conditions at the job site that may affect its productivity as shown in the Table, is most nearly:

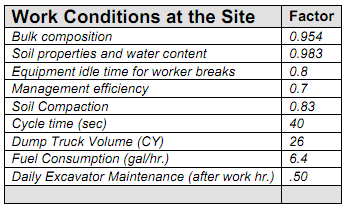

2411_Productivity Analysis and Improvement.png

Solution:  Note that all the factors are less than 1, as such; the job site productivity of the excavator per day is given by:

 Pday = (2,160yds3)(.954)(.983)(.8)(.7)=1,134yds3

The actual cycle time can be determined as follows:

Tactual = 40sec/(.954)(.983)(.8)(.7) = 76sec


Related Discussions:- Example for productivity analysis and improvement

Determining the amount of pre-camber, 1. Domes - You are a construction man...

1. Domes - You are a construction manager in the UAE in charge of a project that involves constructing domes.  Discuss briefly, giving examples, a range of different types of dome

Calculate the total duration for the four activity project, Calculate the T...

Calculate the Total Duration for the Four Activity Project Solution:      Scheduling work activity has associated time duration. The durations shown in the Table were e

Chapter 9, define of window pivoted

define of window pivoted

Civil Engineering, I. A horizontal 500 lb force acts at a point D of cranks...

I. A horizontal 500 lb force acts at a point D of crankshaft AB which is held in static equilibrium by a twisting couple and by reactions at A and B. Knowing that the bearings are

Extreme fiber stresses at the mid span section of the beam, Extreme fiber s...

Extreme fiber stresses at the mid span section of  the beam A pre-stressed concrete beam, of  cross section 300 mm x 500 mm and 8 m span, is pre-stressed with a parabolic tend

Design of flexible pavements - road pavements, Design of Flexible Pavements...

Design of Flexible Pavements: The design of flexible pavements is done by the CBR method. The CBR test, described further, gives an indication of the supporting power of the

Brigdes, infomation about differnt brigdes

infomation about differnt brigdes

What is partial prestressing, What is Partial Prestressing It is a form...

What is Partial Prestressing It is a form of prestressing in which tensile stresses are permitted, upto a limited extent, in concrete under working loads. As the permitted tens

Write Your Message!

Captcha
Free Assignment Quote

Assured A++ Grade

Get guaranteed satisfaction & time on delivery in every assignment order you paid with us! We ensure premium quality solution document along with free turntin report!

All rights reserved! Copyrights ©2019-2020 ExpertsMind IT Educational Pvt Ltd
