Determine the project duration and critical path, Civil Engineering

Assignment Help:

Critical Path - Activity on Node

The project precedence table shown below provides the relationships and durations of all activities. Based on end-of-day calculations for starts and finishes, use a critical path analysis to determine the project duration and Critical Path.

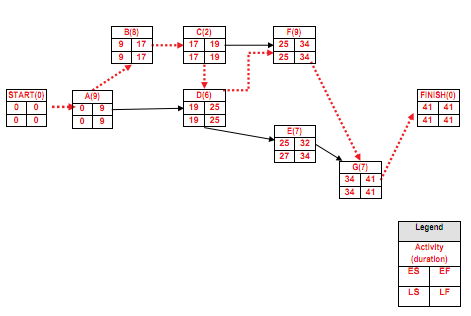

1029_determine the project duration and Critical Path 1.png

Where there are multiple paths between subsets of activities, analyze the subsets to find the longest time path, then string together the longest subset paths to complete the critical path from start to finish.  To clarify the situation, sketch the project network, showing activities, durations, and the critical path.

a)    Total days to Finish = 41.

 b)    The critical path is as follows:  START, A, B, C, D, F, G, FINISH

2076_determine the project duration and Critical Path 2.png


Related Discussions:- Determine the project duration and critical path

EIA, limitations of EIA

limitations of EIA

Show the side clearance of pipes in trenches, Side clearance of pipes in tr...

Side clearance of pipes in trenches From the design point of view, it's predominant to minimize the width of pipe trenches due to thebelow reasons: (i)  Higher cost of exca

Explain standard penetration test used in soil exploration, Explain the "St...

Explain the "Standard Penetration Test" used in soil exploration. List the information that can be obtained by the test when made in (a) clay, (b) sand. Comment on the correctio

Vibration in structures – resilient bearings, Q. Vibration in structures - ...

Q. Vibration in structures - resilient bearings? When railway tunnels are built close to buildings, ground-borne vibration is transmitted to buildingsthrough compression and sh

Varignon theorem, how to prove varignon theorem in easiest way

how to prove varignon theorem in easiest way

Determine equipment purchase yields a minimum 15% return, A contractor esta...

A contractor established a policy to purchase equipment over leasing only if the return is a minimum of 15%. Given the following conditions, the contractor's decision based on the

Show the probable type of clay mineral, The liquid limit and plastic limit ...

The liquid limit and plastic limit of clay are 100% and 25%, respectively. From a hydrometer analysis it has been found that the clay soil having of 50% of particles smaller than 0

Binders - cement, Binders : Cement: Cement as a Binder Cement...

Binders : Cement: Cement as a Binder Cement is one of the main ingredients of concrete. When cement sets (with the addition of water), it forms a paste and binds the

Write Your Message!

Captcha
Free Assignment Quote

Assured A++ Grade

Get guaranteed satisfaction & time on delivery in every assignment order you paid with us! We ensure premium quality solution document along with free turntin report!

All rights reserved! Copyrights ©2019-2020 ExpertsMind IT Educational Pvt Ltd
