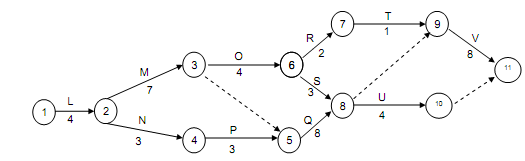

For the project network shown, the late start time (day) for activity "Q" is most nearly:
Solution: List the paths leading to "Q" and calculate the duration for each.
L M = 4 + 7 = 11-days
L N P = 4 + 3 + 3 = 10-days
Q's early start time is 10-days
Q's late start time is 11-days
A simply-supported beam (AB) with an overhang (BC) is illustrated in Figure 1(a), with the cross-sectional details given in Figure 1(b). The dead load comprises self weight only; f
With a clear sketch indicate the system of protection of line for works of short duration where ‘ Stop dead restriction' need to be observed on a single line section on a BG track.
Multi Speed Restriction (i.e. existence of two or more than two speed restrictions in continuation) When work of deep screening or sleeper renewal is in progress, there is situ
HOW TO ACHIEVE THAT
derive equation of radial pressure and loop stresses of thick cylinder
Q. Granular fill or rock fill essential at the base of concrete retaining walls? It isn't uncommon that rock fill layers and granular fill layers are placed beneath the bottom
Arrangement of piles in a pile cap to reduce bending moment induced in piles Let's consider that piles are designed to intersect at a single common point in a pile cap. The re
design calculations for a two storey office building
description and details about distomat
definion of local attraction and correction
Get guaranteed satisfaction & time on delivery in every assignment order you paid with us! We ensure premium quality solution document along with free turntin report!
whatsapp: +91-977-207-8620
Phone: +91-977-207-8620
Email: [email protected]
All rights reserved! Copyrights ©2019-2020 ExpertsMind IT Educational Pvt Ltd
