Reference no: EM133518005
Planning and Control Assignment
Project to Arrange for Conference

|
|
Schedule mode*
|
Best case
|
Most typical case
|
Worst case
|
Expected duration
|
Standard deviation
|
|

ID speaker topics
|
ASAP
|
1
|
3
|
5
|
|
|
|
Contact speakers
|
ASAP
|
8
|
9
|
12
|
|
|
|
Select hotel
|
ASAP
|
4
|
5
|
7
|
|
|
|
Arrange hotel accommodations
|
ASAP
|
2
|
4
|
4
|
|
|
|
Arrange catering
|
ASAP
|
4
|
5
|
7
|
|
|
|
Develop brochure
|
ASAP
|
7
|
9
|
12
|
|
|
|
Print and mail brochure
|
ASAP
|
4
|
8
|
8
|
|
|
|
Develop exhibit material
|
ASAP
|
10
|
12
|
15
|
|
|
|
Develop workbook
|
ASAP
|
4
|
5
|
7
|
|
|
|
Print and bind workbook
|
ASAP
|
3
|
5
|
6
|
|
|
|
Final set-up for conference
|
ALAP
|
2
|
3
|
5
|
|
|
|
*ASAP = schedule task as soon as possible ; ALAP = schedule task as late as possible; Unit= Days
|
Question 1. The table for this assignment provides best case, most typical case, and worse case estimates of task duration for each task. Using the PERT Beta distribution formulas, compute the expected time for achieving each task and its standard deviation.
Question 2. How long will the project take to carry out?
Question 3. What is the standard deviation of the critical path?

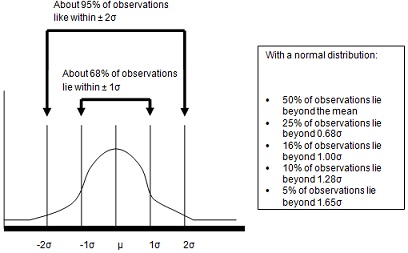

Question 4. What is project duration when 1σ (standard deviation) is added? 2σ? (Note that when dealing with normal distributions, about 68% of observations lie within ±1 σ and about 95% of observations lie within ±2σ. We do not have a normal distribution in this case. We are working with a PERT Beta distribution that is not fully symmetric. Still, using an assumption of normality, we can get a very rough sense of the probability that a project will slip its schedule by 1σ or 2σ.)
Question 5. Identify latest start, earliest start, and float times for each of the tasks in this project.
|
|
Expected duration
|
Latest Start
|
Earliest Start
|
Float
|
|
ID speaker topics
|
|
|
|
|
|
Contact speakers
|
|
|
|
|
|
Select hotel
|
|
|
|
|
|
Arrange hotel accommodations
|
|
|
|
|
|
Arrange catering
|
|
|
|
|
|
Develop brochure
|
|
|
|
|
|
Print and mail brochure
|
|
|
|
|
|
Develop exhibit material
|
|
|
|
|
|
Develop workbook
|
|
|
|
|
|
Print and bind workbook
|
|
|
|
|
|
Final set-up for conference
|
|
|
|
|
Question 6. An opportunity arises to have "Develop workbook" and "Print workbook" carried out earlier, in parallel to the other tasks. "Develop workbook" can begin as soon as "ID speaker topics" is complete. Reconfigure the PERT/CPM network to reflect this change in work. How much time has been saved on the project?
